Skip to main content

Chargeback and Cost Centers

✨Enterprise Feature

Part of the CodeMie Enterprise package, and may not be enabled on every deployment. If this capability is missing from the UI described below, contact the CodeMie platform administrator. See all Enterprise features.

A project budget decides how much a project may spend. Chargeback and cost centers decide who pays for it.

  • Chargeback marks a project's spend as billable, so it can be recovered from the team that incurred it rather than absorbed centrally.
  • A cost center groups several projects — a program, a department, or a client engagement — so their combined AI spend settles on one bill.

The two are independent of enforcement: neither blocks a request or changes a limit. They determine where the spend is attributed for internal billing.

Chargeback​

Enabling Chargeback​

Chargeback is configured on the project's budget.

  1. Go to Administration → Projects Management and select the project.
  2. Open the budget dialog — Create Budget for a new budget, or Manage Budget for an existing one.
  3. Switch on Enable chargeback.
  4. Optionally switch on Attribute to a cost center, which appears once chargeback is enabled.
  5. Save the budget.

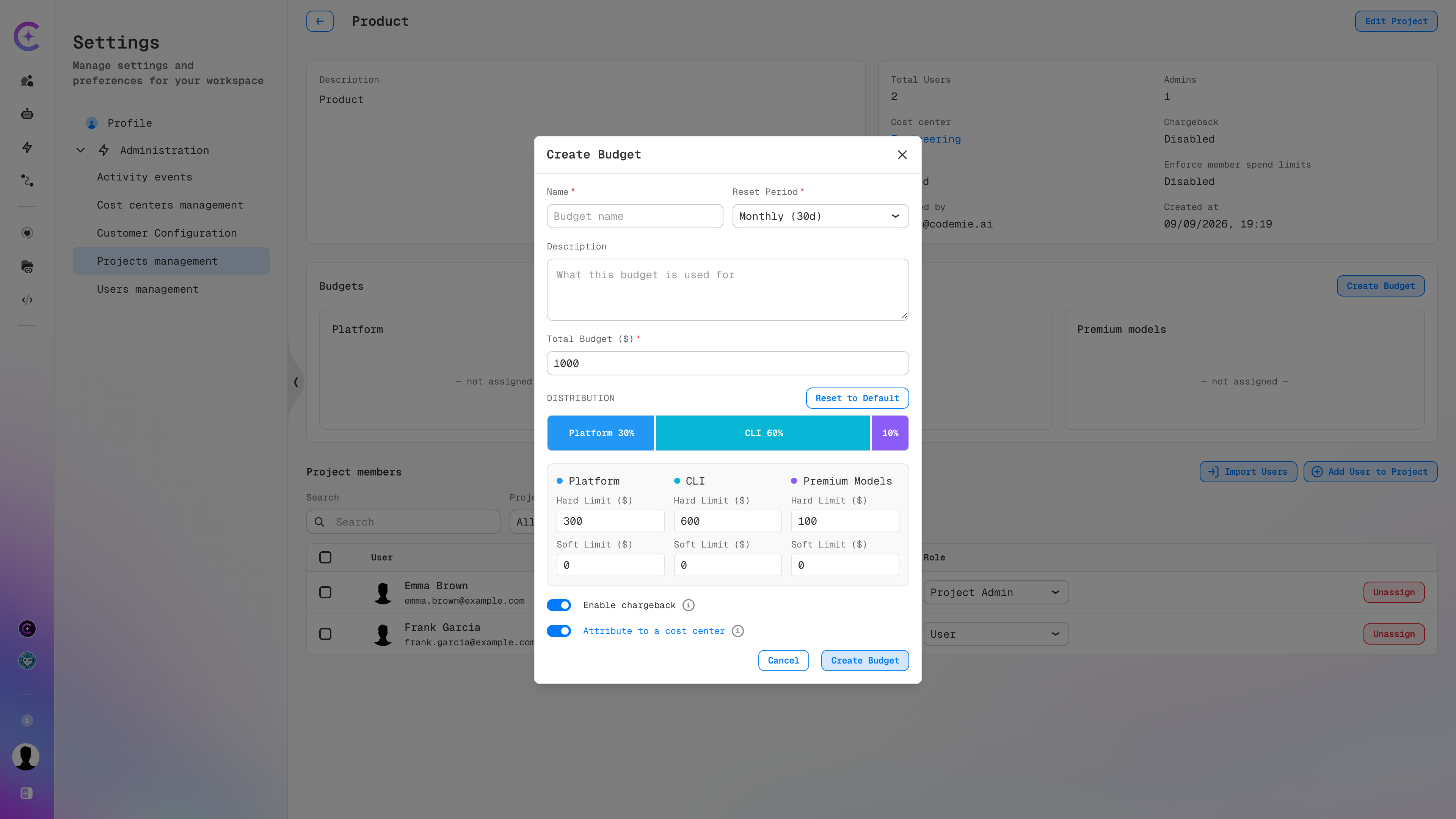

Create Budget dialog with chargeback and cost center attribution enabled

Attribution Targets​

SettingWhere the spend is billed
Enable chargeback offSpend is not tracked for internal billing
Enable chargeback onSpend is billed to the project's own billing code
Enable chargeback on, Attribute to a cost center onSpend rolls up to the cost center assigned to the project instead of the project's own code
note

Attribute to a cost center only takes effect when the project has a cost center assigned. Assign one through Edit Project → Cost center. See Assigning a Project to a Cost Center.

The current state is visible on the project page without opening the budget: the information panel shows Chargeback as Enabled or Disabled, alongside the Cost center the project belongs to.

Cost Centers​

A cost center is a grouping label that aggregates the spend of every project assigned to it. It holds no budget of its own — limits live on the projects, and the cost center simply adds up what they spend.

This keeps the two concerns separate: a project budget controls consumption, while a cost center controls reporting and billing.

Managing Cost Centers​

Path: Profile → Settings → Administration → Cost centers management

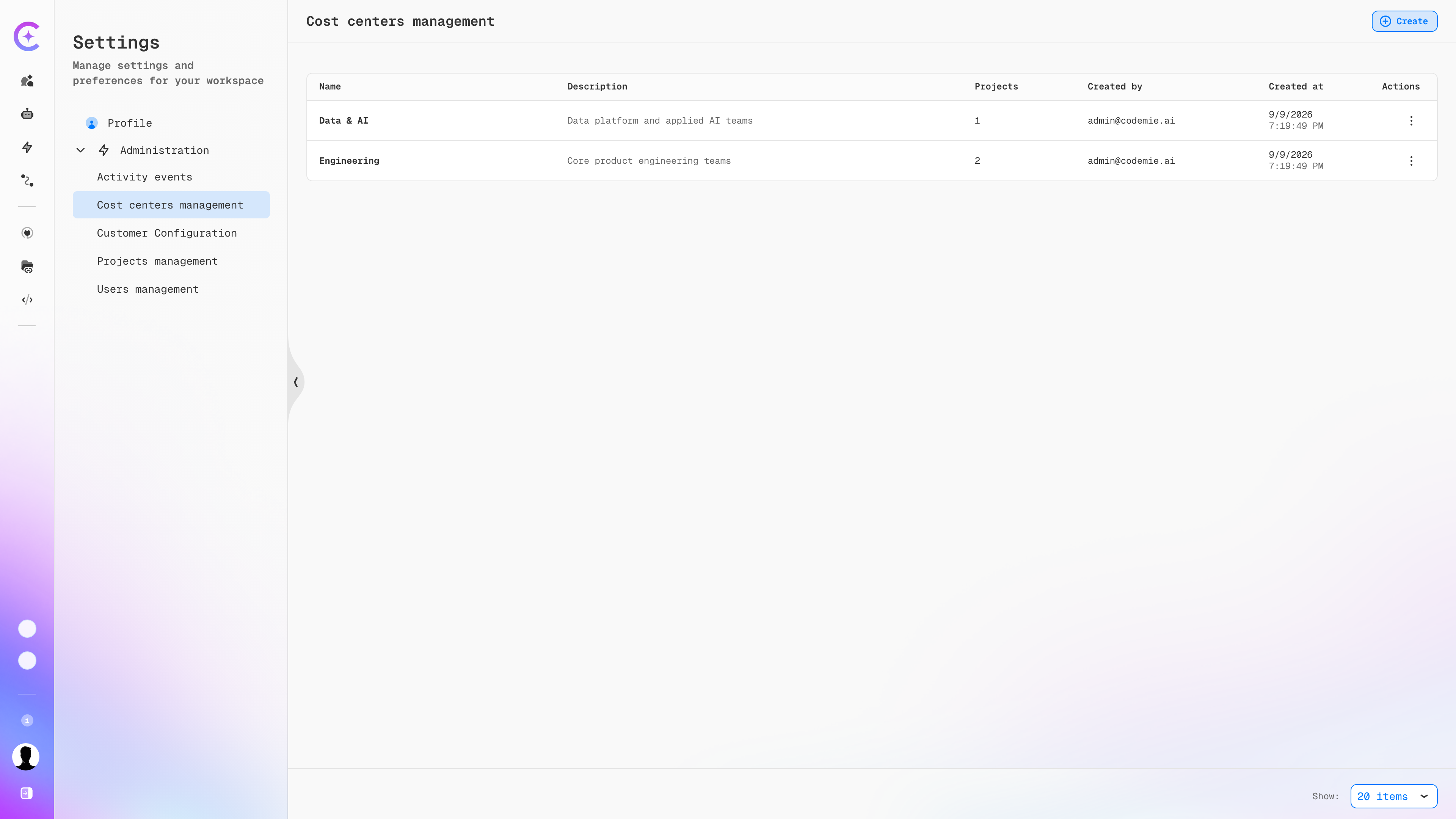

Cost centers management list

The list shows every cost center with its description, the number of projects assigned to it, and creation details.

ColumnDescription
NameCost center identifier
DescriptionWhat the cost center covers
ProjectsNumber of projects currently assigned to it
Created byUser who created the cost center
Created atCreation timestamp
ActionsEdit and delete the cost center

Creating a Cost Center​

  1. Go to Administration → Cost centers management.
  2. Click Create.
  3. Enter a Name and a Description.
  4. Save.
warning

Cost center names must match the pattern configured by COST_CENTER_NAME_PATTERN, which defaults to two lowercase alphanumeric segments joined by a hyphen (for example, platform-core). Names that do not match are rejected. See Cost Center configuration.

Assigning a Project to a Cost Center​

  1. Open the project under Administration → Projects Management.
  2. Click Edit Project.
  3. Select the target cost center in the Cost center field.
  4. Click Save.

The project page then shows the cost center in its information panel, and the Projects count on the cost center increases. A project belongs to at most one cost center at a time; clearing the field removes the association.

info

Assigning a cost center does not by itself redirect billing. The project's budget must also have both Enable chargeback and Attribute to a cost center switched on for its spend to roll up.

Putting It Together​

A typical rollout across a department:

  1. Create a cost center for the department under Cost centers management.
  2. Give each project in the department a budget with the categories and limits that fit the team.
  3. Assign each project to the cost center through Edit Project.
  4. On each project's budget, switch on Enable chargeback and Attribute to a cost center.

Every project then carries its own enforced limit, while the department receives a single combined bill for their AI spend.

See Also​
